These are the weekly snapshots for our Gantt Chart, the more full a bar is, the more complete the task is.

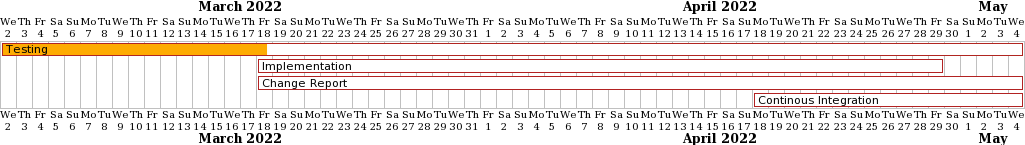

Began testing parts of the game that were already implemented in part 1.

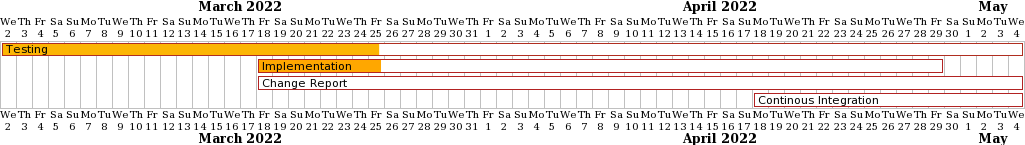

Continued testing while also adding new features to the game.

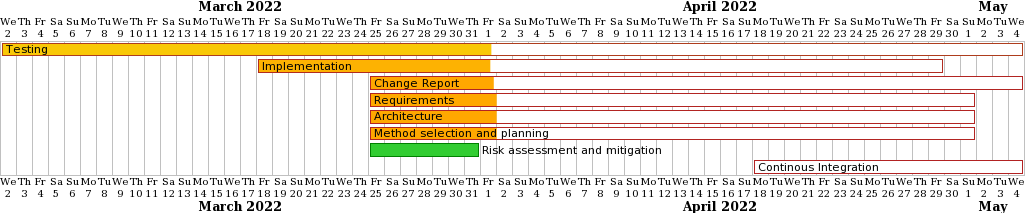

Split the change report into seperate parts in order to track progress of each individual part and the risk assessment report was also complete.

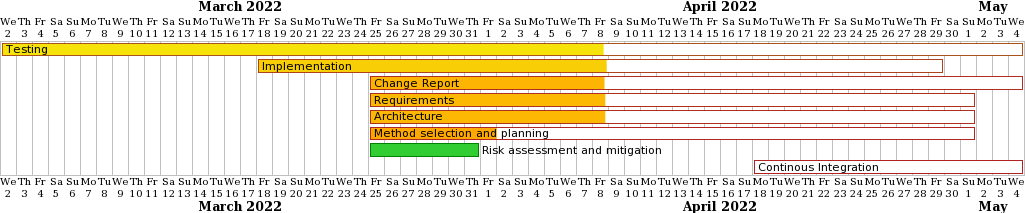

Continued working on the parts we’ve already begun.

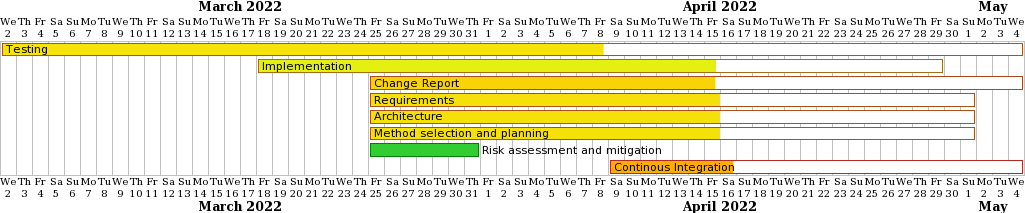

Began continous integration and continued to progress on all other parts except for testing.

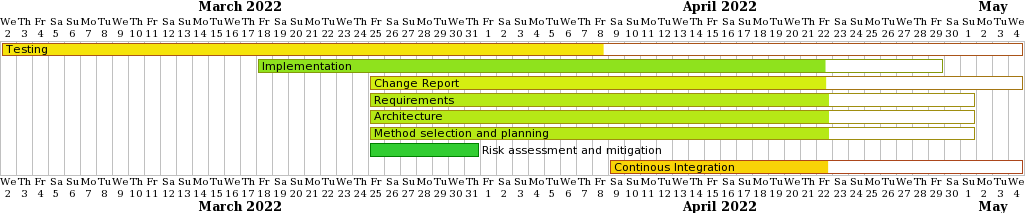

More progress was made on all parts of the project and are almost complete.

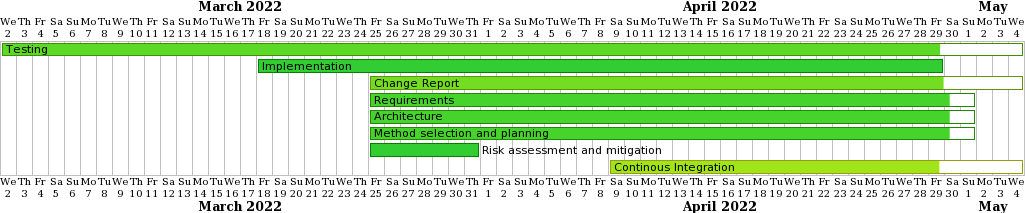

Implementation is complete and major progress was made on testing.

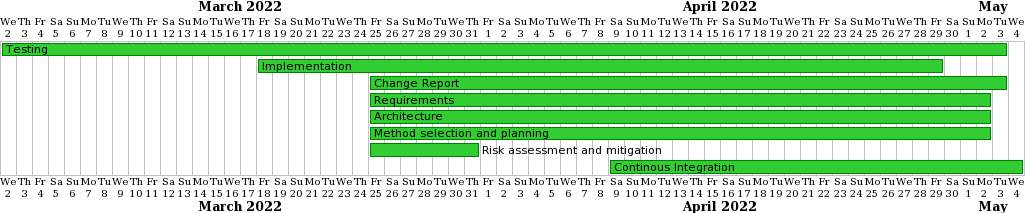

All sections of the project were completed.
